AI Factories Turn Copper Into India’s Next Digital Bottleneck

AI data centers drive copper demand higher even with 800V cuts; India’s import gap now threatens timelines and costs for its planned 12 GW buildout.

Published

on

AI data centers are set to lift global copper demand in that sector from 1.1 million metric tons in 2025 to 2.5 million metric tons by 2040, according to S&P Global forecasts circulating across commodity desks. India sits in the same wave while still importing more than half its copper needs. That gap now reaches the capital budgets of every hyperscale and colocation project on the country’s drawing boards.

Higher-voltage power designs cut copper per megawatt. Absolute volumes still climb because rack densities and total capacity are rising faster. For Indian operators the metal has become a schedule and cost variable as real as power or land.

Global Copper Bills for AI Racks Keep Climbing

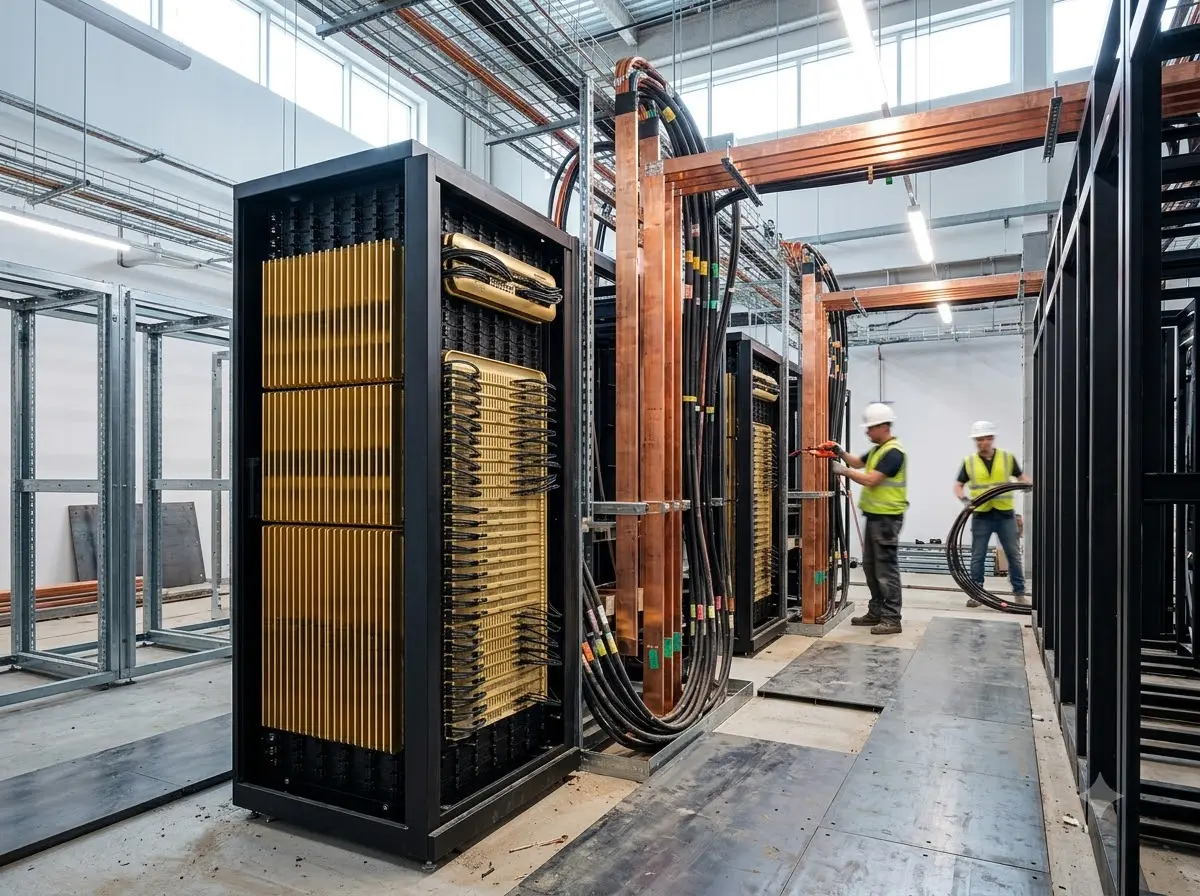

Conventional data centers already use thousands of tons of copper for busways, transformers, cooling loops and grid ties. AI training clusters raise the intensity. Analysts cite figures ranging from roughly 6-8 tonnes per megawatt for standard power distribution up to 27-47 tonnes per megawatt in high-density GPU halls. A single hyperscale AI facility can lock in as much as 50,000 tons.

S&P Global’s central case puts data-center and associated infrastructure copper use at 1.1 million metric tons in 2025 and 2.5 million by 2040. Scenario bands run from 1.7 million to 2.7 million depending on how fast AI capacity and supporting generation grow. Other houses land near 330,000-420,000 tonnes a year by 2030 for data centers alone, with peaks near 572,000 tonnes earlier in some BloombergNEF-linked tallies.

Source / Metric Figure Horizon
S&P Global DC + infra copper 1.1 MMt to 2.5 MMt 2025-2040
Macquarie / Fastmarkets range 330-420 kt/year 2030
High-density intensity 27-47 t per MW Current AI clusters
Hyperscale facility example Up to 50,000 t Single campus

Grid reinforcements often multiply the metal requirement several times beyond the building itself. Crowd tallies on X have circulated the same order of magnitude, with one widely shared note putting roughly 27,000 tonnes of copper inside a single large AI data center. The numbers vary by design, yet the direction is consistent: copper is no longer a background line item.

Why 800-Volt Designs Still Leave a Heavy Bill

NVIDIA and partners are pushing 800 VDC distribution precisely to tame copper and conversion losses. In NVIDIA’s technical write-up the same wire gauge can carry 157% more power than 415 VAC. A simpler three-wire DC layout replaces four-wire AC runs. Copper use drops, connectors shrink, and cable management eases as rack inlets head toward megawatt scale.

Enverus Intelligence Research models the economics more sharply. Versus legacy 415 VAC, 800 VDC can cut electrical capex about 13 percent, lift end-to-end facility efficiency from 79.8 percent to 93.8 percent, and reduce copper mass by up to 60 percent per megawatt. NVIDIA itself has cited copper requirement cuts on the order of 45 percent in related architecture notes.

  • Power density path: racks already past 100 kW and heading higher force higher voltage.
  • Copper mass: up to 60% less per MW under Enverus modeling.
  • Efficiency: multi-stage AC-DC conversions drop out of the path.
  • Capex: roughly 13% lower electrical spend in the modeled case.

These gains are real. They do not reverse the demand curve. More megawatts of AI capacity and the generation and transmission that feed them still pull more metal in absolute terms. Aluminum substitution works better on long high-voltage lines than inside dense racks where thermal conductivity and space constrain options. Copper remains non-negotiable for much of the IT and cooling plant.

India’s Capacity Pipeline Multiplies the Stake

Wood Mackenzie projects India’s operational capacity from 2.2 GW to 12 GW between 2025 and 2030, a roughly 40 percent compound annual growth rate. AI-dedicated capacity is expected to expand nearly 24-fold, from 275 MW to about 6,546 MW over the same window. Hyperscalers, cloud providers and enterprise digitalisation all contribute.

That buildout sits on the same copper physics as projects in the United States or the Gulf. Similar regional races already surface power and materials pressure; the Gulf AI data center buildout risks show how quickly energy and logistics constraints reshape timelines. India’s operators inherit the same metal intensity while starting from a thinner domestic supply base.

Even modest intensity assumptions translate into tens of thousands of tonnes of additional copper demand inside India by the end of the decade once grid connections are counted. Price spikes or concentrate shortages would hit capital expenditure directly and could stretch delivery schedules for power equipment and busbar systems.

Domestic Mines and Smelters Still Lag Demand

The Centre for Social and Economic Progress mapped the gap in its India Copper Report demand and supply gaps. Conventional-sector copper demand is projected near 3.24 million tonnes by FY 2030, with energy-transition uses adding another 274 thousand tonnes. India remains import-reliant for more than 50 percent of its needs. Known reserves at current rates last roughly 45 years; exploration success has been low and mine grades are modest.

Hindustan Copper Limited is the sole domestic ore producer. Ore output has hovered near 4 million tonnes a year, a small fraction of metal requirement. Private custom smelters import concentrates. Hindalco’s Birla Copper operations have supplied more than half of domestic refined copper in recent tallies. Vedanta’s Tuticorin smelter closure earlier removed roughly 40 percent of cathode capacity and turned India into a net cathode importer. Adani’s Kutch Copper plant has begun adding 0.5 million tonnes of processing capacity, with another similar unit targeted later in the decade.

Player Role Noted capacity or status
Hindustan Copper (HCL) Only domestic miner ~4 Mtpa ore; expansion plans to 12.2 then 20.2 Mtpa
Hindalco (Birla Copper) Primary refined supplier Meets >50% domestic refined needs in recent years
Vedanta / Sterlite Smelter (Tuticorin closed) Closure cut national cathode output ~40%
Adani Kutch Copper New processing 0.5 Mt plant online; further capacity planned

Government and think-tank documents put copper ore resources at about 1.66 billion tonnes of copper ore resources, yet only a small share counts as economic reserves, concentrated in Rajasthan, Madhya Pradesh and Jharkhand. Concentrate imports have run into the millions of tonnes and billions of dollars annually. One policy paper cited by Reuters projected India may still import 91-97 percent of concentrates by 2047 under current trajectories. Demand itself could reach 3-3.3 million tonnes by 2030 and far higher by mid-century.

Operators Absorb the Price and Timeline Risk

Copper sits inside every power train: transformers, switchgear, busways, UPS systems, cold plates and the cabling that ties racks to the facility backbone. A sustained price rise or delivery delay raises both up-front capital outlays and the cost of later expansions. Colocation providers and hyperscalers in India already juggle power availability, land and fiber. Adding a strategic metal shortage tightens the same schedule.

Fluctuations feed straight into project IRRs and competitive positioning against other Asian hubs. Indian digital infrastructure ambitions, including the AI capacity ramp WoodMac outlines, become more expensive or slower if metal markets tighten faster than domestic supply responds. Secondary effects reach equipment vendors and EPC contractors who must quote long-lead copper-intensive gear.

Local market commentary on X has already framed mid-cap copper fabricators and recyclers as quiet beneficiaries. That crowd read is consistent with the physics: value-added rods, busbars and secondary metal gain leverage when primary supply stays tight. The same logic that lifted optical and GPU supply chains now applies further upstream.

Policy Levers and Midstream Fixes Arrive Late

CSEP and ORF papers both call for faster exploration auctions, clearer statutory clearances, and higher private participation in mining. HCL’s staged mine expansions to 12.2 Mtpa then 20.2 Mtpa would help if executed on time. New smelting and refining capacity from Adani and others can cut cathode import dependence, yet they still need concentrate feedstock.

Recycling remains underdeveloped and largely informal. Formalising scrap collection, raising purity standards and linking e-waste streams to smelters would add a domestic buffer. Extended producer responsibility rules and quality-control orders need calibration so they do not choke cathode availability for fabricators while still protecting standards.

Trade diversification away from any single concentrate supplier, joint ventures with foreign miners, and possible overseas equity stakes form the foreign-policy half of the response. India is already discussing deeper ties with Chilean and other producers. None of these moves is instantaneous. Mines take a decade; smelters take years; recycling scale-up takes consistent regulation.

Parallel industrial capacity in India already shows the country can move quickly when incentives align, from smartphone assembly to Samsung’s India R&D AI feature work. Copper requires the same sustained attention at the resource and midstream layers.

The Binding Constraint Shifts Upstream

Chip supply and power purchase agreements still dominate headlines. Copper now sits beside them as a physical limiter on how fast AI factories can be energised and expanded inside India. Efficiency gains from 800 VDC reduce intensity but raise the strategic value of every remaining tonne. India’s import share and thin reserve base turn global tightness into a domestic competitiveness issue.

Operators will keep building. The question is the premium they pay in metal cost and schedule slip, and how quickly policy and private capital close the production gap that the AI capacity targets have made visible again.
